01/22/21  Next Council meeting:  Tuesday, January 26, 1:30 pm       Agenda
    Of particular interest to those in Ward 5…
1) 4A Amendments to city ordinances re Fireworks

2) 4B Conditional use for RV Park on Debuys Road
3) 4D Resolution supporting local & private bill, low-speed vehicles
4) 5D Renewal of management agreement with Mardi Gras Museum

01/22/21    I received a small card  (front  back) from Mississippi Power Company in the mail this week… They’ll be in the River Place subdivision in the coming weeks to trim trees and perform other vegetation management tasks.  (You might want to check your mail to see if you received a notice about your neighborhood.) Questions? 800.532.1502

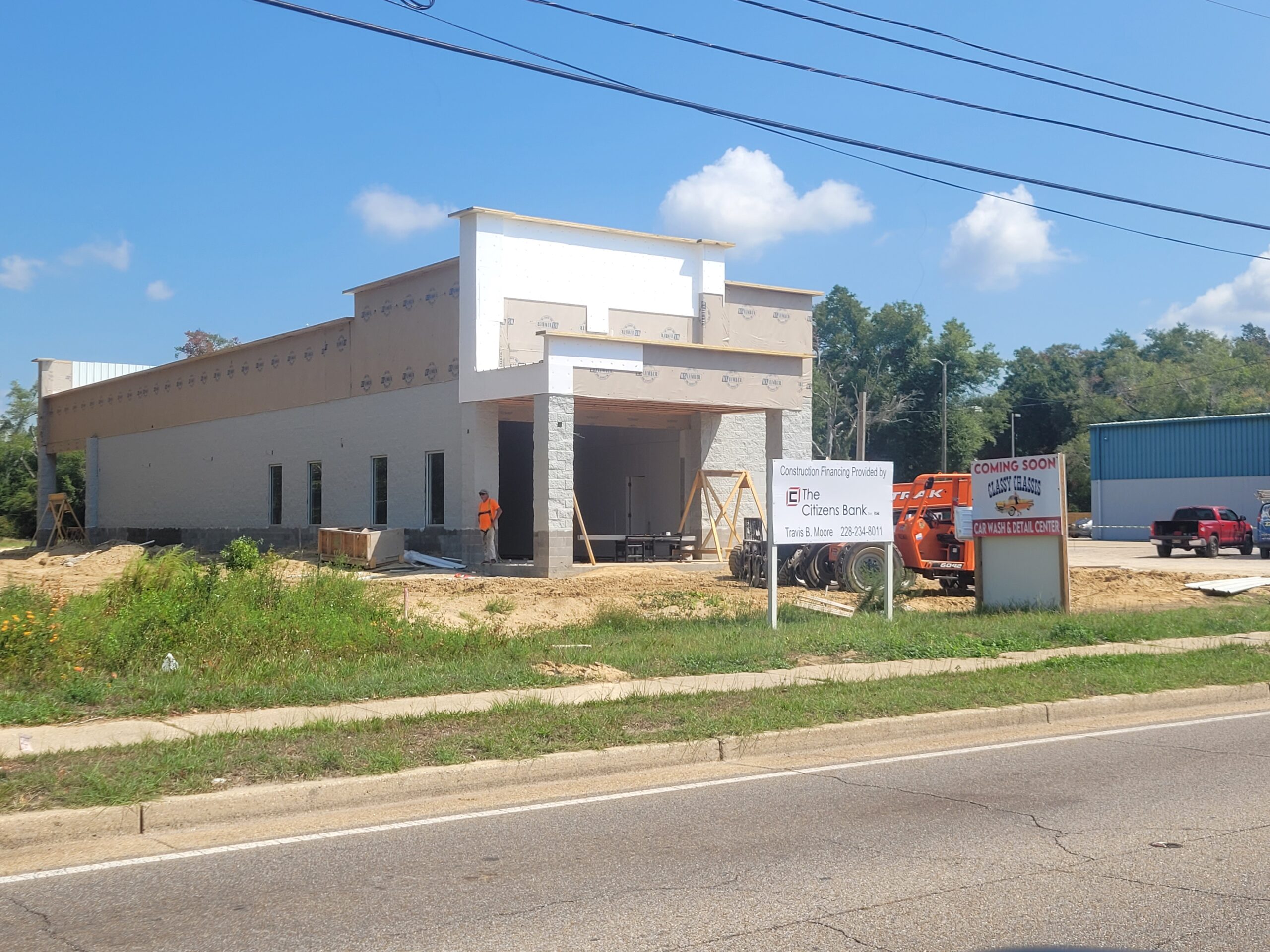

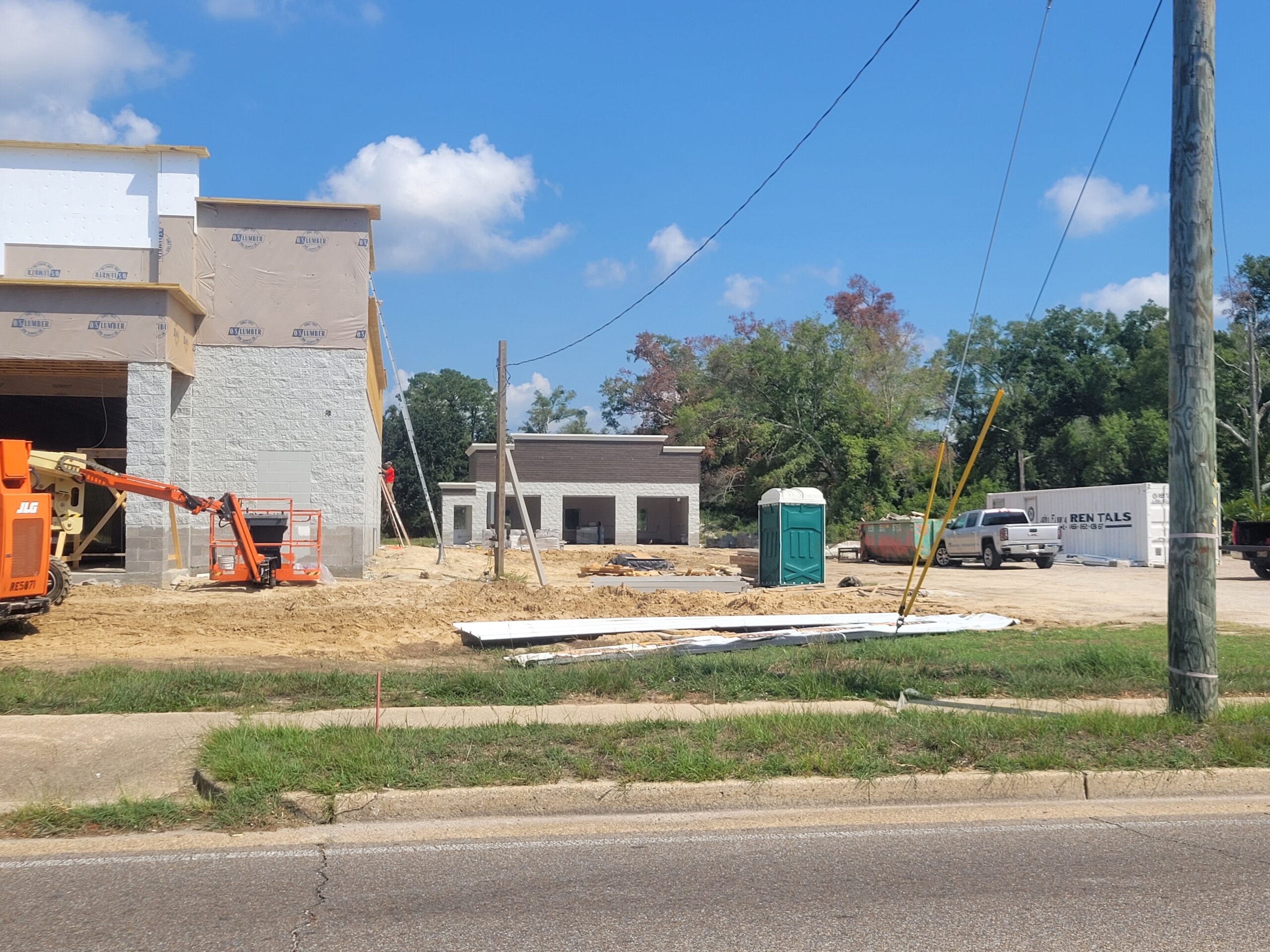

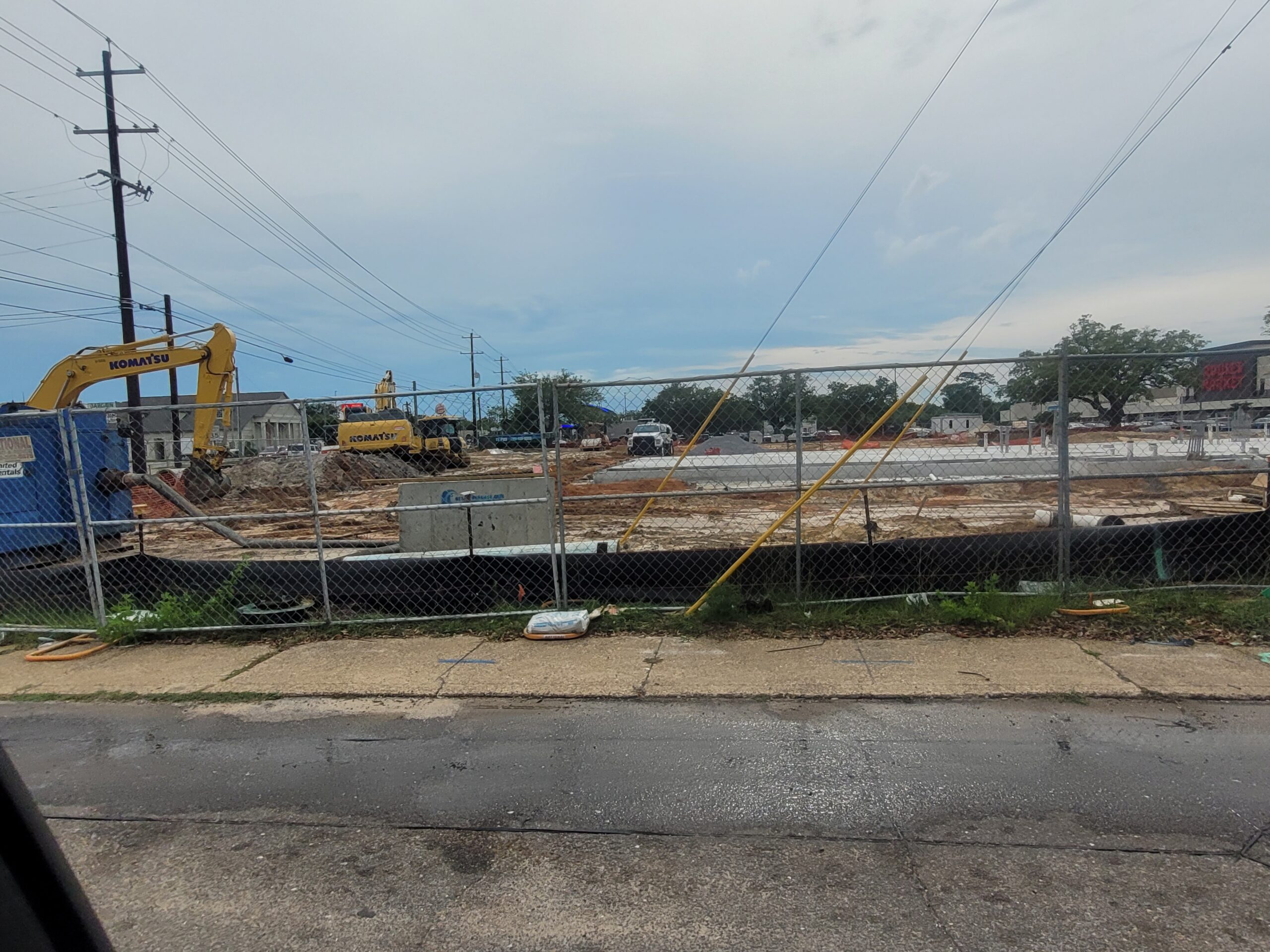

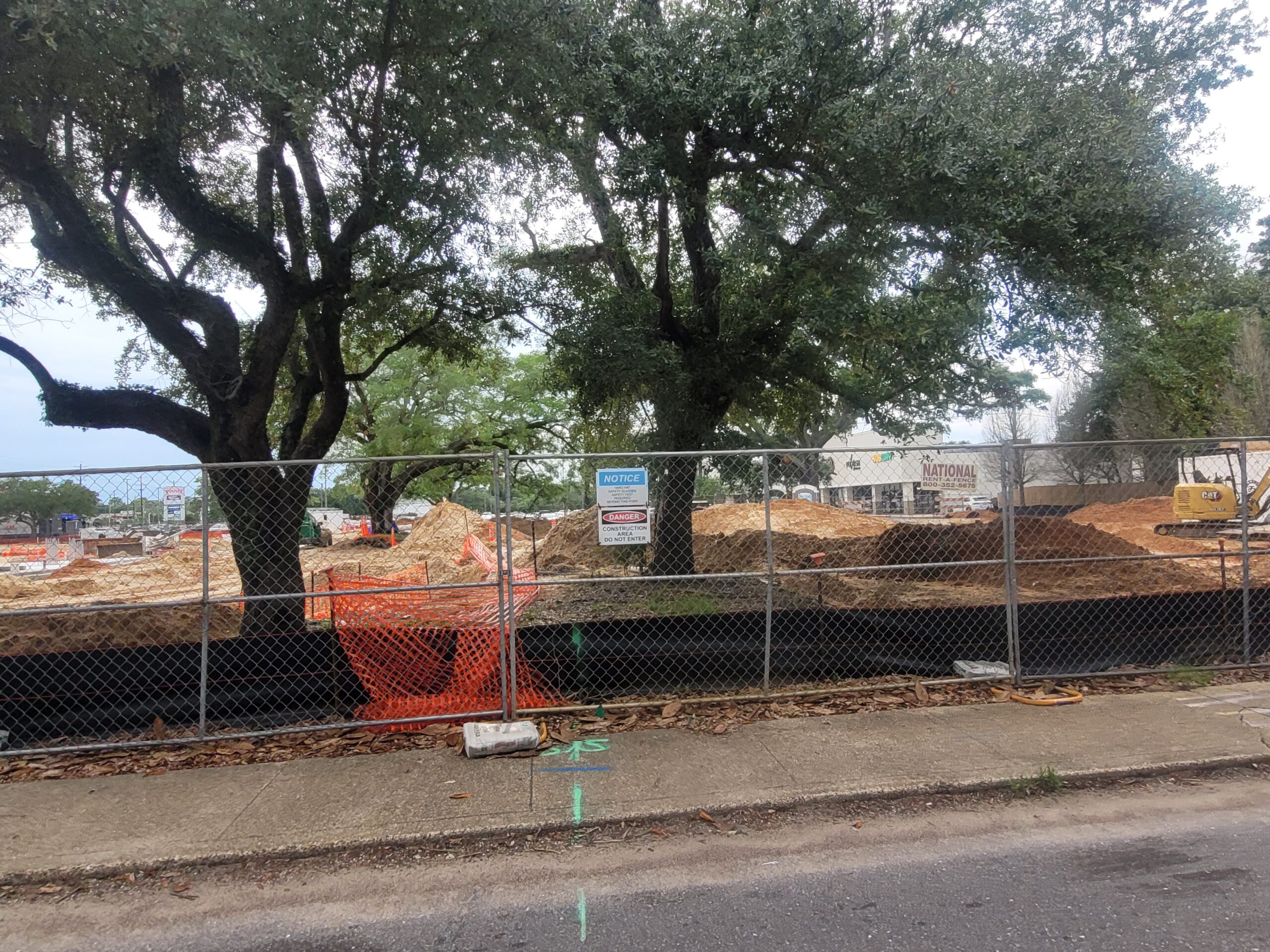

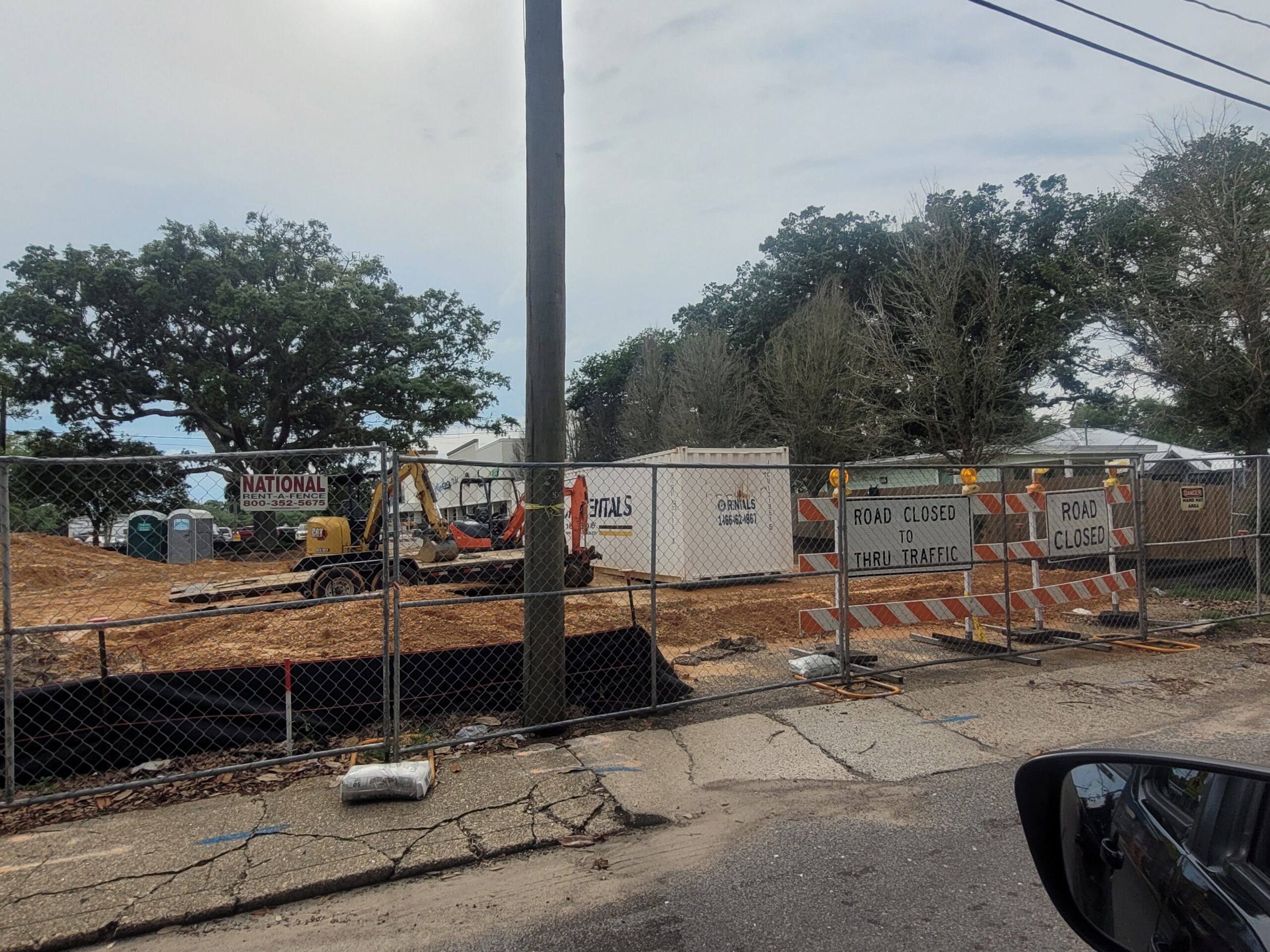

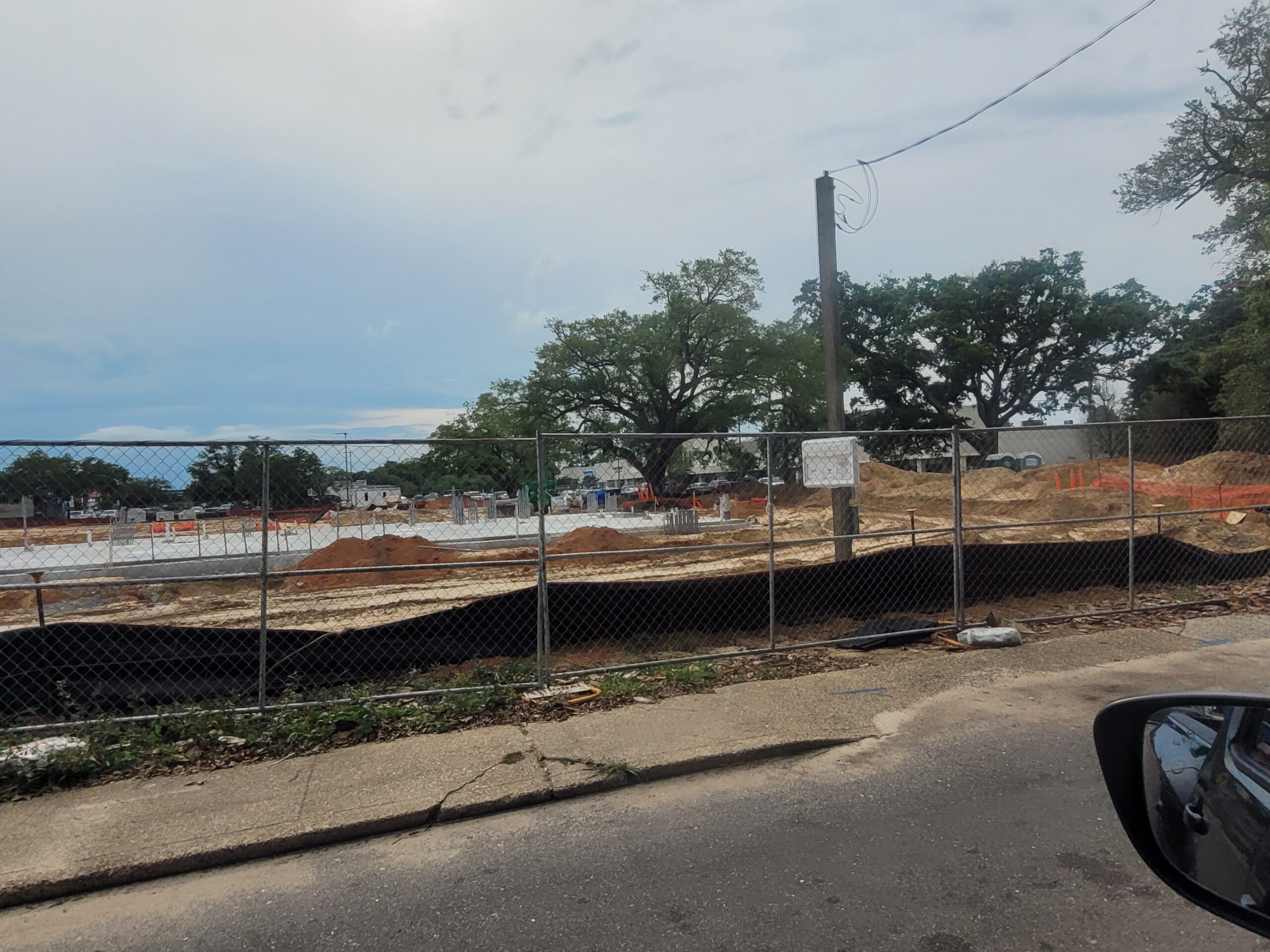

01/22/21  Keesler Air Force Base new Main Gate is scheduled to be open about a year from now.  The pic below shows that infrastructure construction has already begun on the base property.  Work to widen Division Street from the I-110 ramp west to Forrest Avenue and the new Main Gate has already begun.  See pics of  Division Street, to be widened for this project

01/16/21  I drove the streets in Ward 5 again today and made a list of addresses that still have piles of vegetation only, debris only, or mixed (vegetation & debris) for Public Works to add to their city-wide pickup list.  Pretty much anything that’s not picked up by the contracted debris hauler in the next couple of days will be picked up by Biloxi Public Works crews.  So, be patient… they’ll be working these pickups as fast as they can… in addition to emergencies that arise and their regularly scheduled tasks that keep the city running!

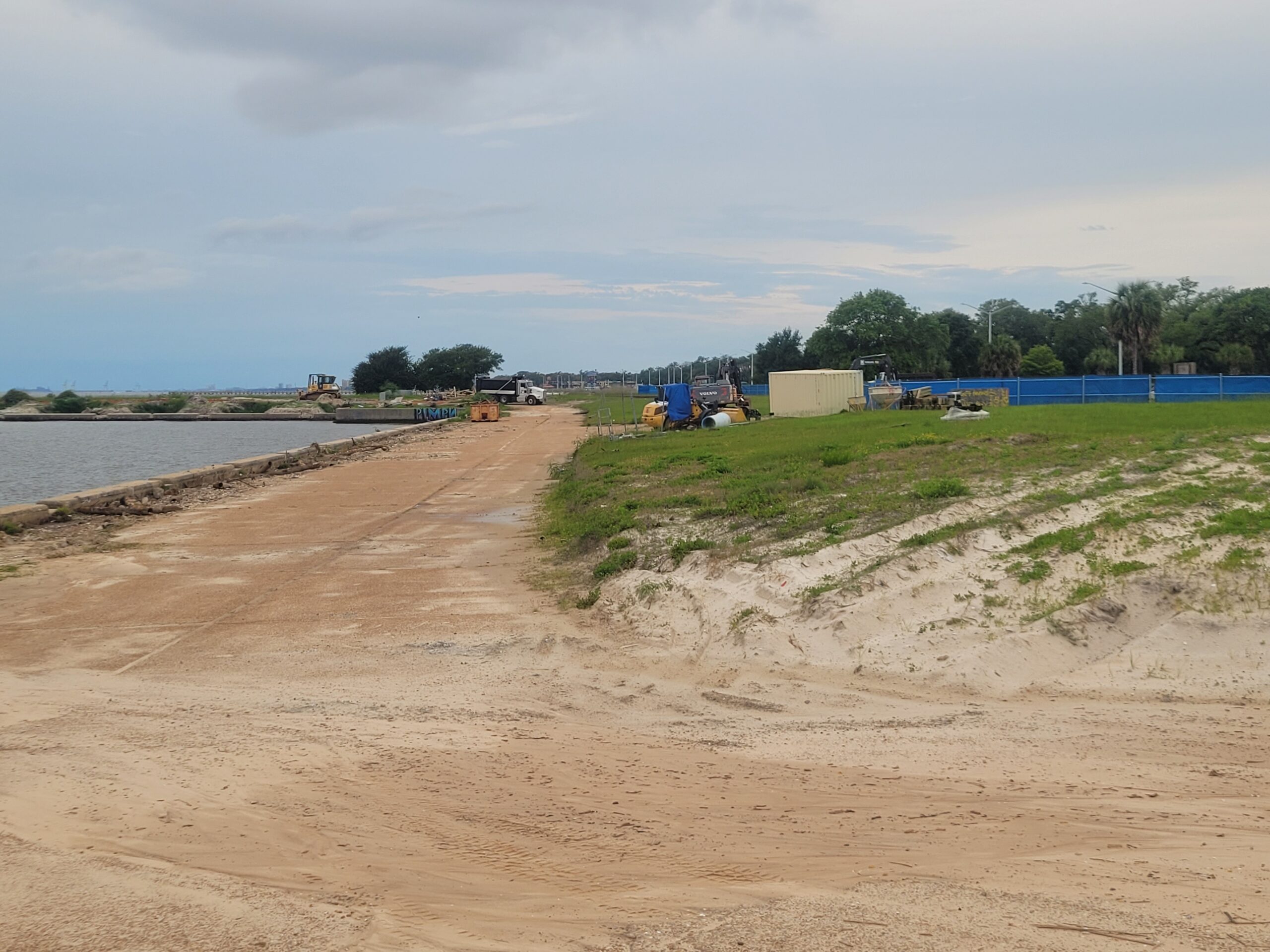

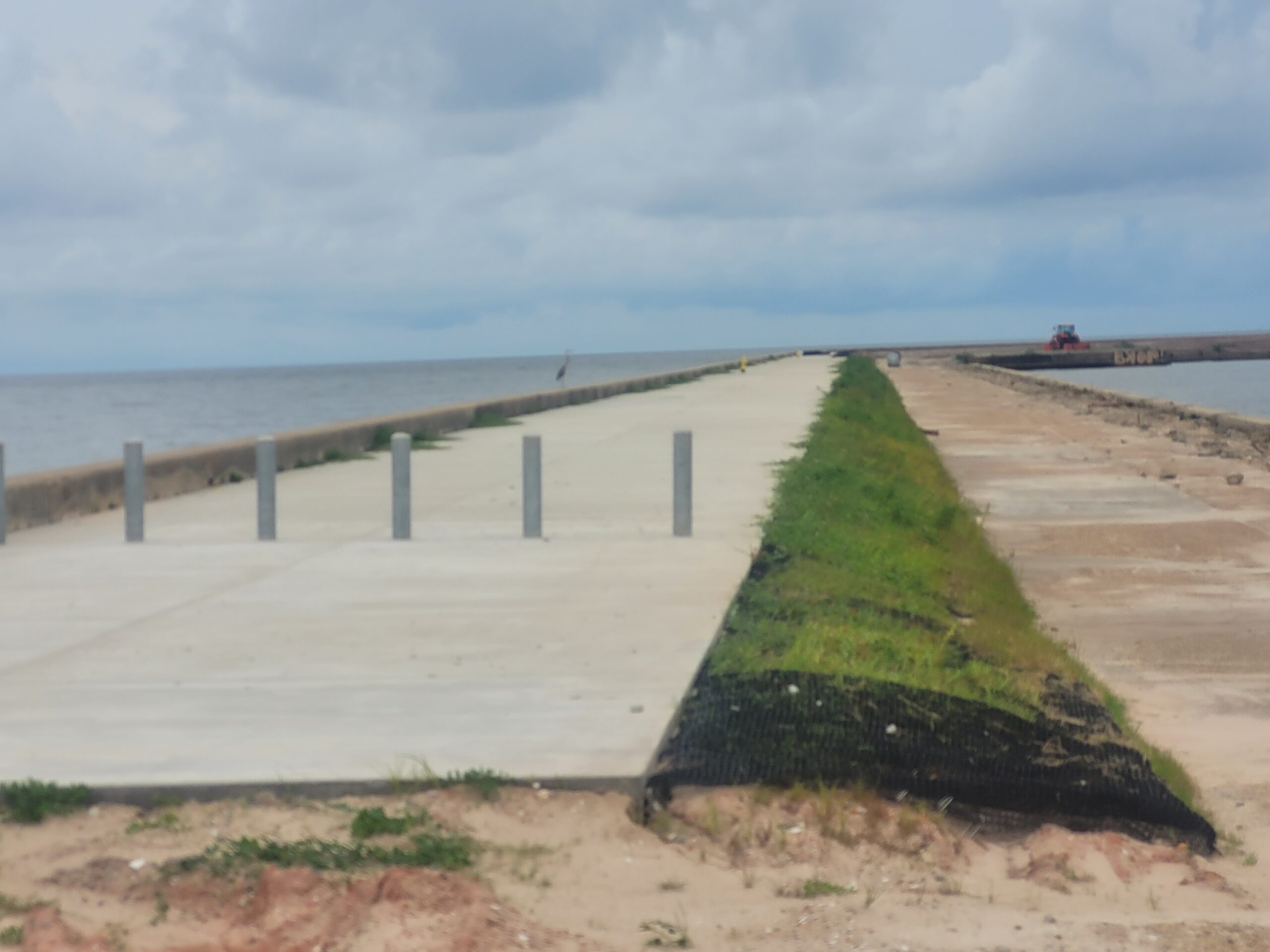

01/11/21  Construction is scheduled to begin soon on the latest boardwalk along Biloxi’s waterfront, on Back Bay from Forrest Avenue to Kensington.  This $2.2M boardwalk project (funded by a GOMESA grant and a Tidelands grant) is scheduled to be completed in late September or October… learn more

12/16/20  Compare water, sewer & garbage rates with our neighbors

06/14/20 Hurricane Katrina infrastructure projects; still ahead…
   The “North Project” (roughly Biloxi Bay to the beach, from Forrest Avenue to Point Cadet) has gotten a lot of attention because it’s huge and has taken years more to complete than anticipated… some would say never ending.  But, the North Project is nearing completion… Oscar Renda Contractors are wrapping up pipe installation repairs before putting a final layer of asphalt down on the remaining roads. Finishing fence replacements, incomplete sidewalks, etc., will continue for the next several months.

   All Hurricane Katrina infrastructure projects north of the railroad tracks (and those north of Biloxi Bay) have been completed with the exception of the North Project .

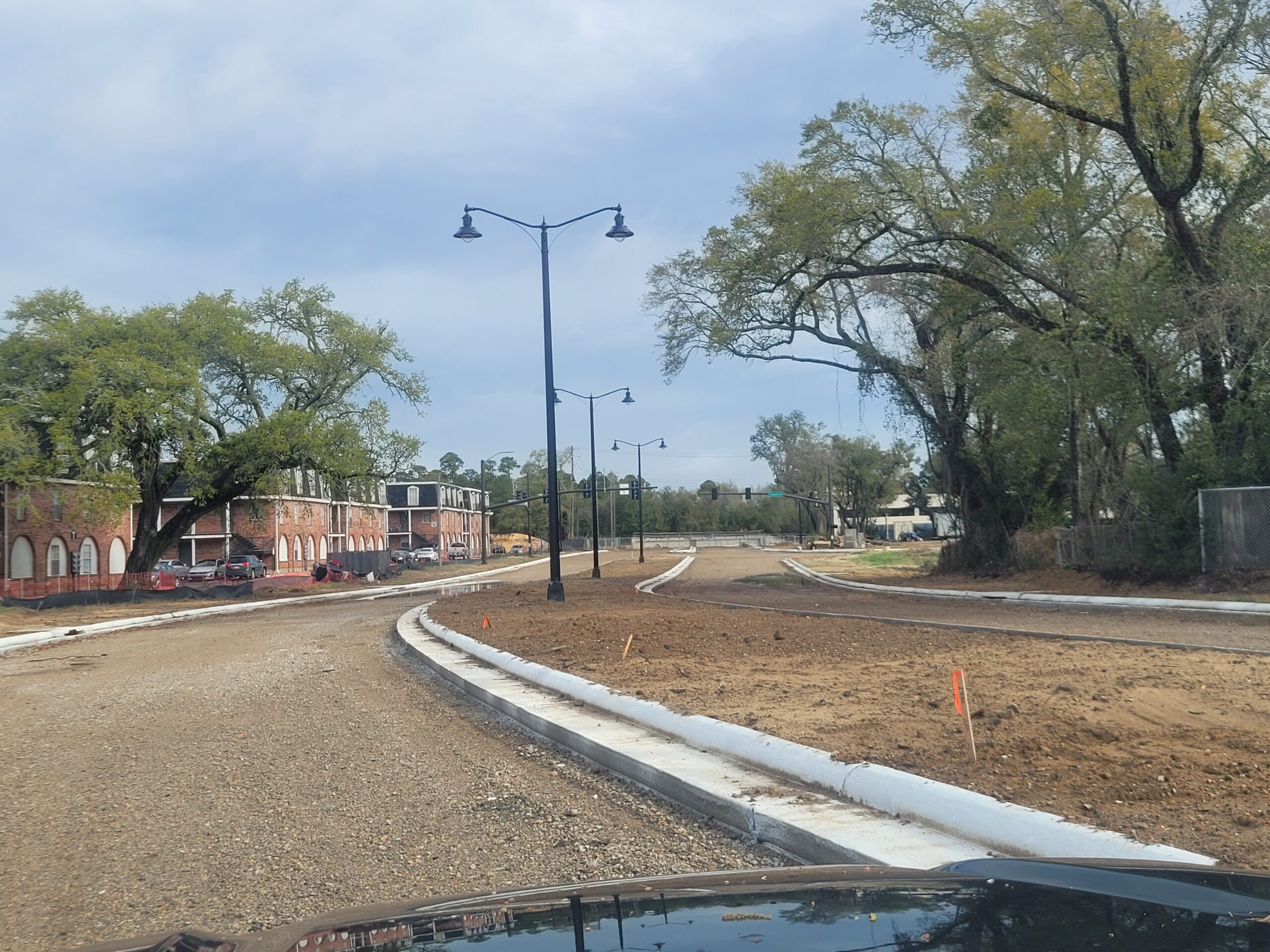

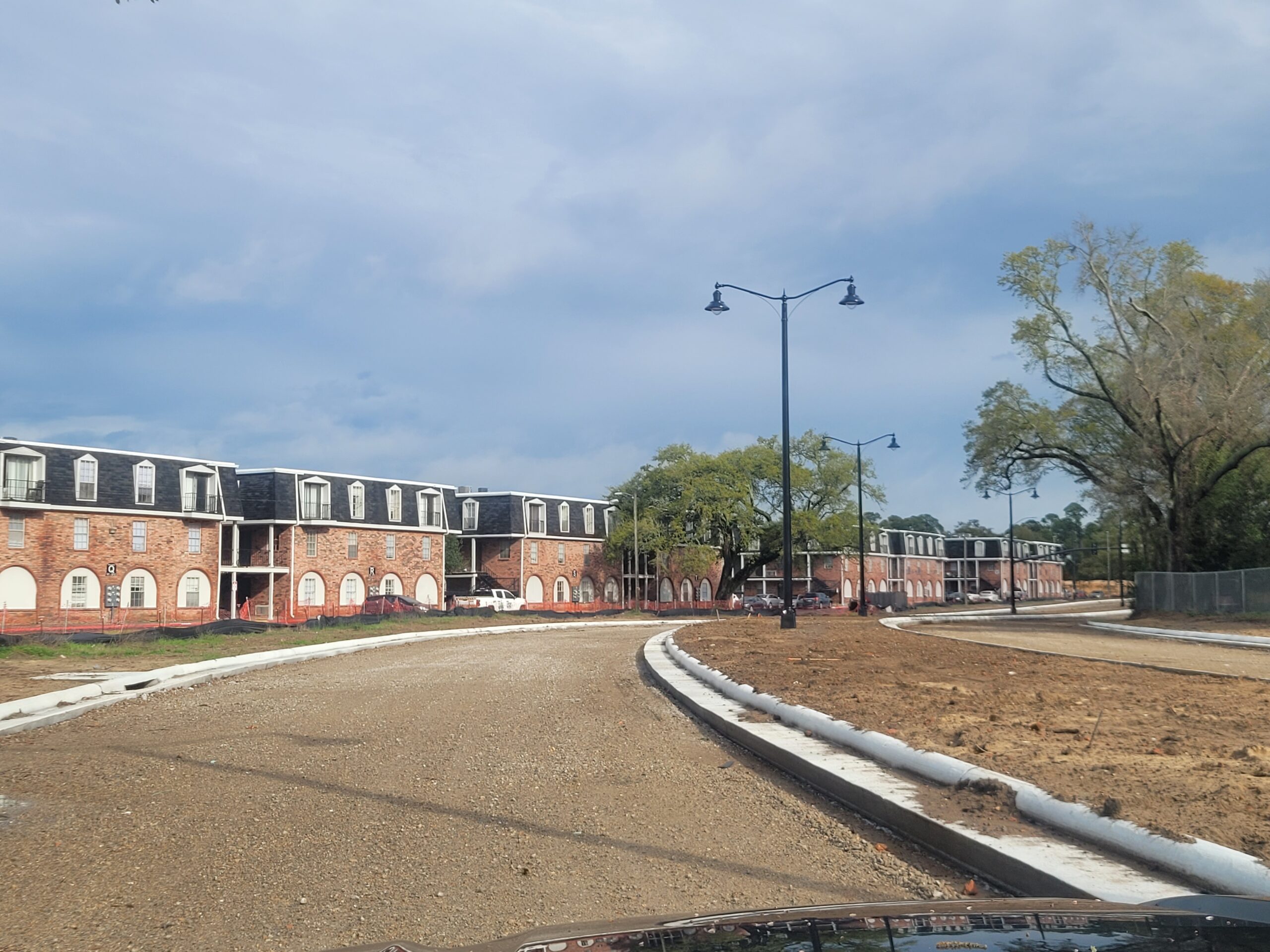

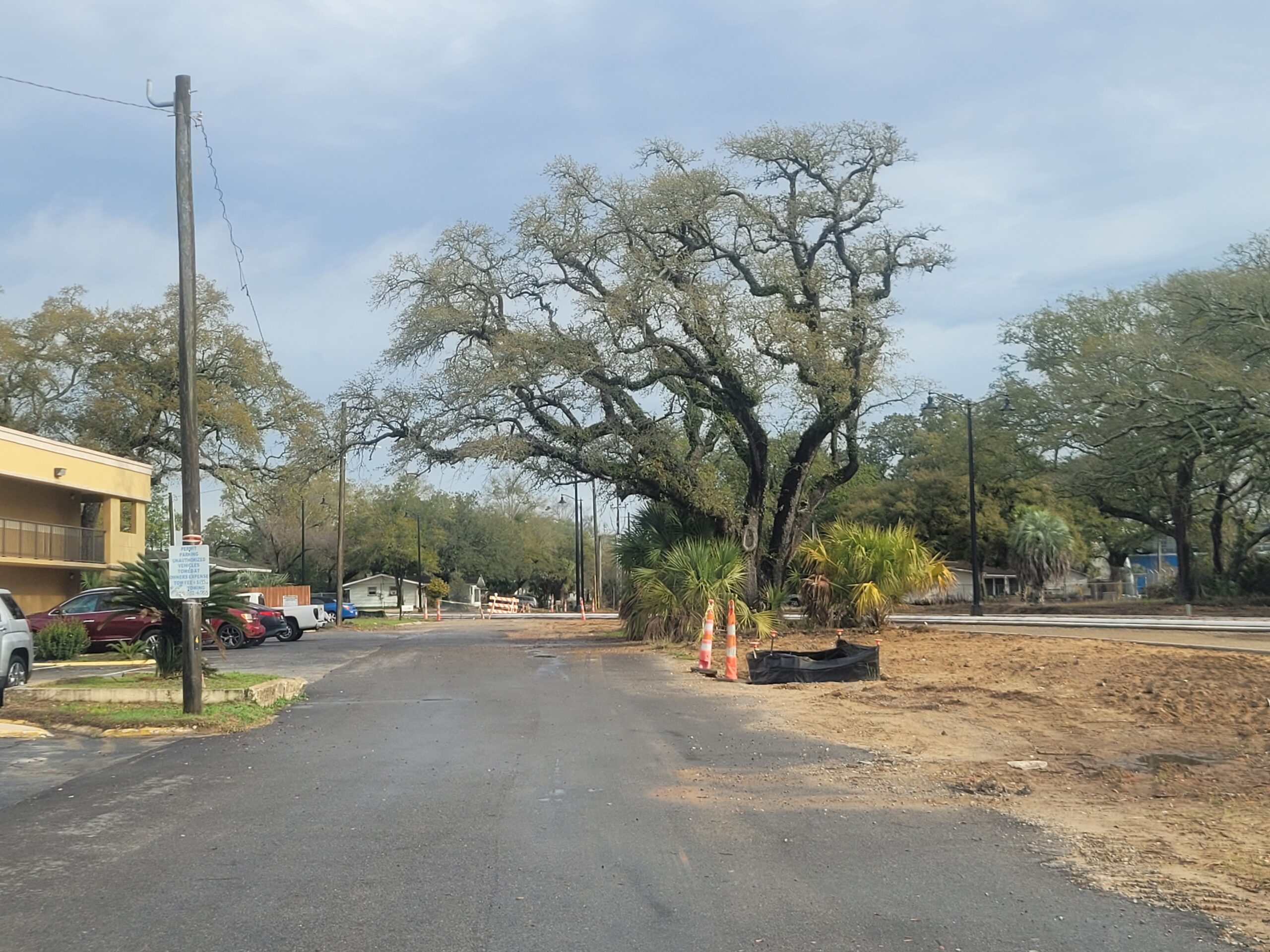

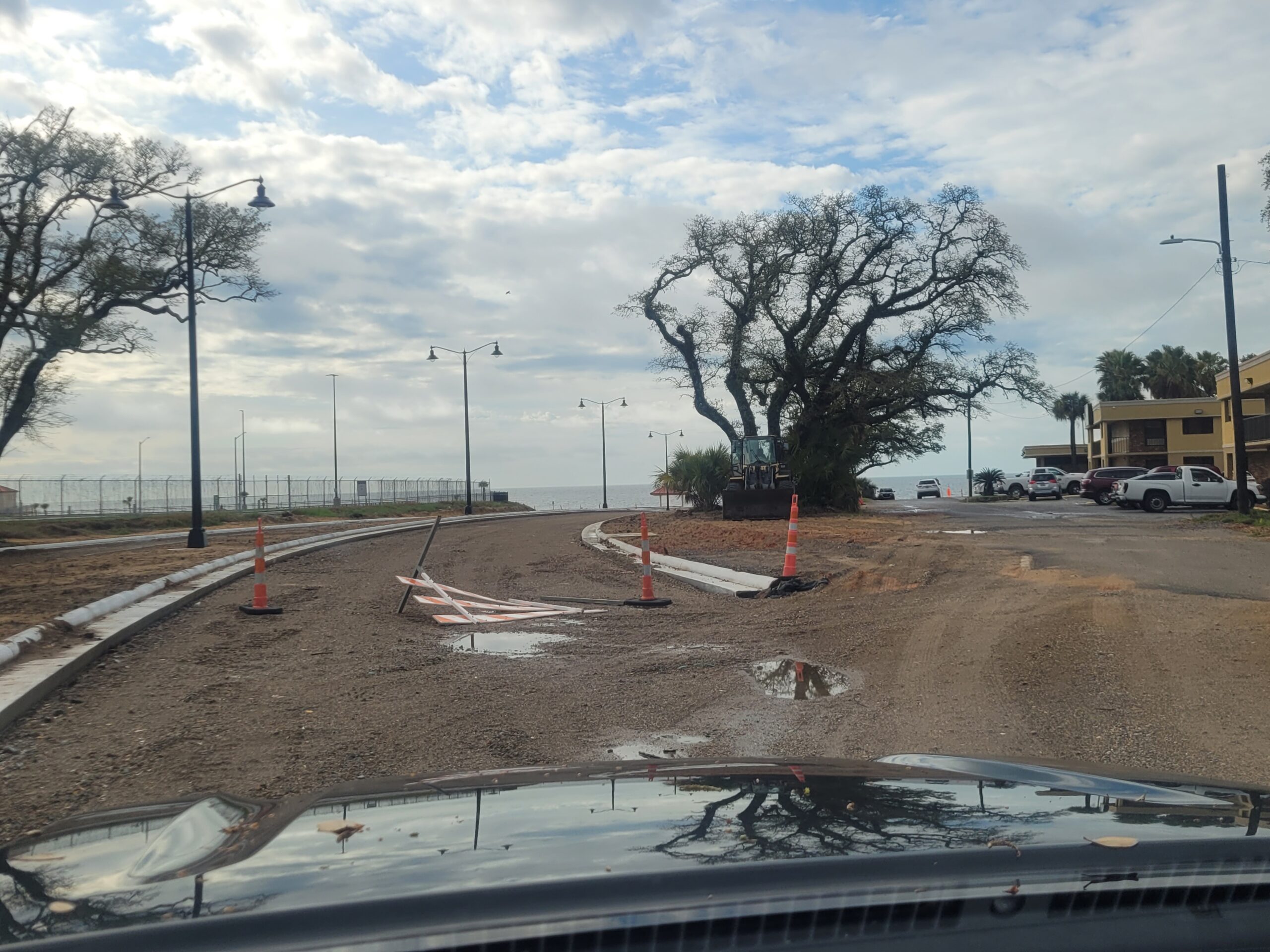

   Still, more projects lie ahead… all south of the railroad tracks.   See Map

Project Code Contractor Est Finish Est Cost
SXSS Lane Construction   Fall, 2021 $11.0M
STM1 & STM2 Necaise Brothers Summer 2023 $32.0M
BEA1, BEA2, BEA3  Bid award, early 2021 18 months $18.2M
ROD9 Bids in summer 2021 N/A $15.3M
BVE1 & BVE2 Bids in spring 2022 N/A $24.1M

   After bids are awarded but before construction begins to replace the water lines, sewer lines, drainage lines, roads and sidewalks, a pre-construction meeting will be scheduled for an explanation of what will be occurring and to answer questions neighborhood residents may have.  If you live in one of those neighborhoods, be sure to attend!  It’s been my experience that only about 10% of the residents, if that many, attend these pre-construction meetings… they’re for your benefit.
